Dockerfile.
Before continuing, make sure you have:
- A Bun application ready for deployment
- A DigitalOcean account
- DigitalOcean CLI installed and configured
- Docker installed and added to your
PATH
1
Create a new DigitalOcean Container Registry

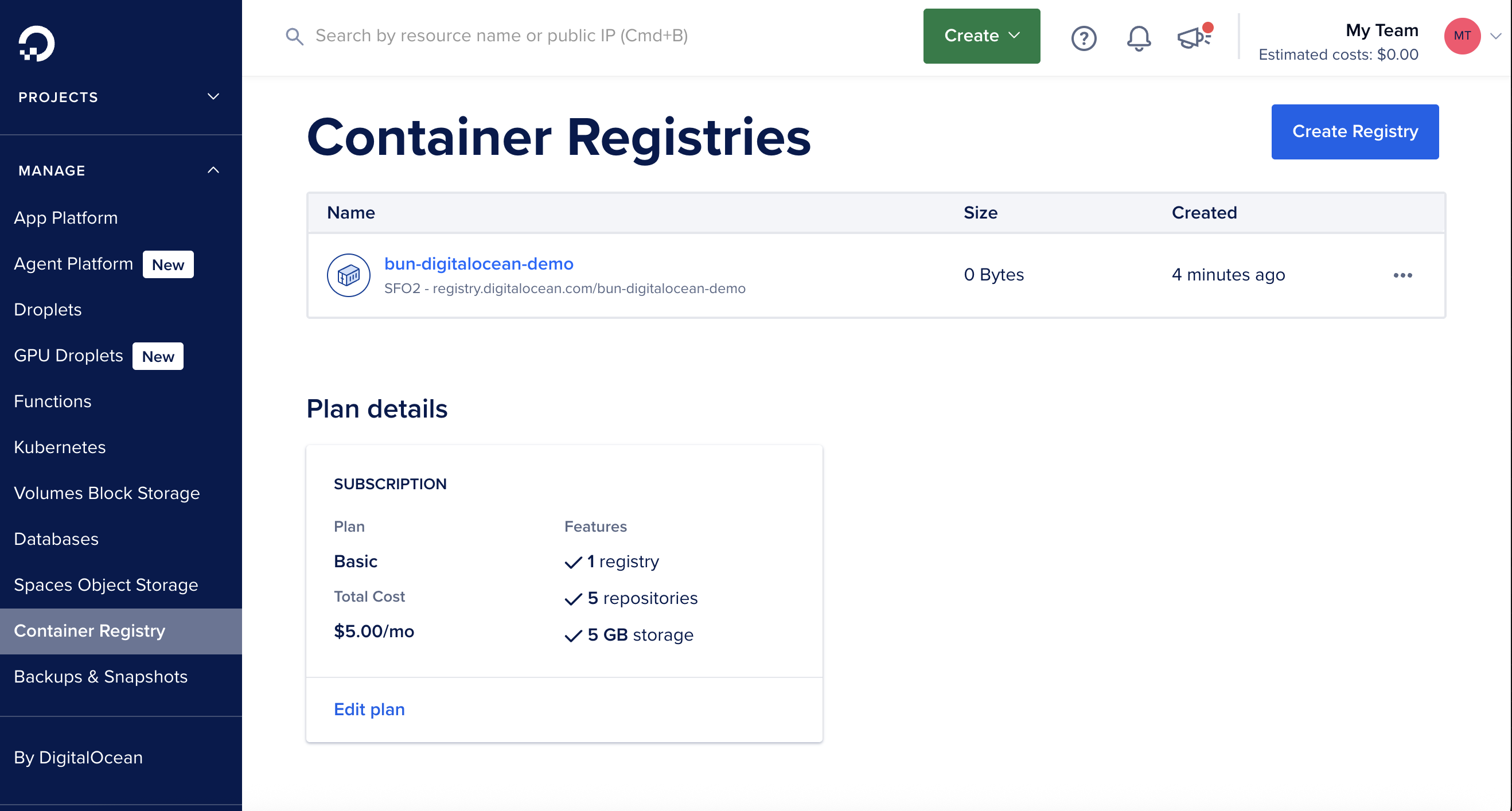

Create a new Container Registry to store the Docker image.You should see the new registry in the DigitalOcean registry dashboard:
- Through the DigitalOcean dashboard
- Through the DigitalOcean CLI

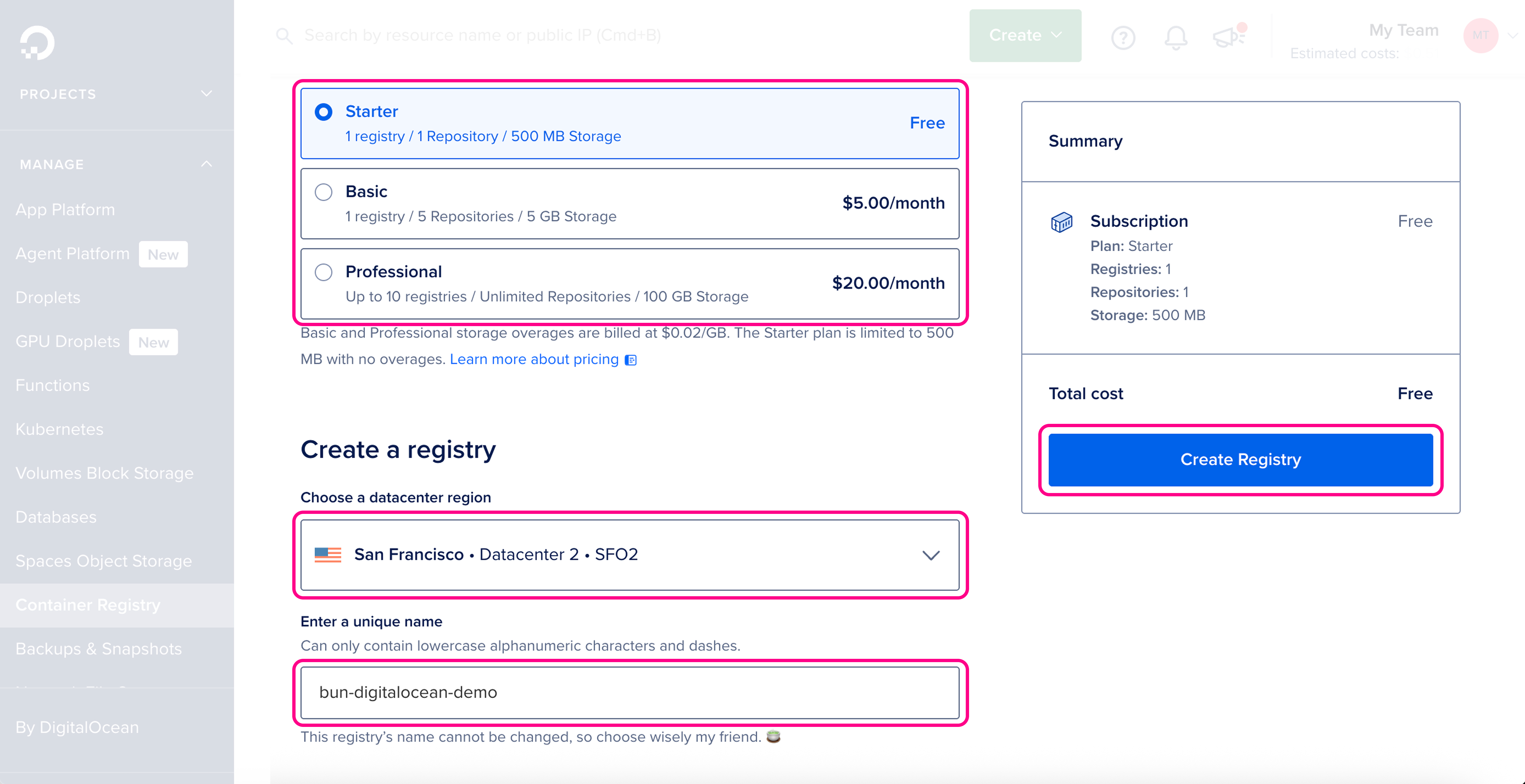

In the DigitalOcean dashboard, go to Container Registry, and enter the details for the new registry.
Make sure the details are correct, then click Create Registry.

2
Create a new Dockerfile
Create a new Create a new
Dockerfile in the root of your project. This file contains the instructions to initialize the container, copy your local project files into it, install dependencies, and start the application.Dockerfile
Make sure that the start command corresponds to your application’s entry point. This can also be
CMD ["bun", "run", "start"] if you have a start script in your package.json.If your app doesn’t have dependencies, you can omit the COPY package.json bun.lock ./ and RUN bun install --production --frozen-lockfile lines (Bun doesn’t write a bun.lock for a project with no dependencies)..dockerignore file in the root of your project. It lists the files and directories to exclude from the container image, such as node_modules, which keeps builds faster and smaller:.dockerignore
3
Authenticate Docker with DigitalOcean registry
Before building and pushing the Docker image, authenticate Docker with the DigitalOcean Container Registry:
terminal
This command authenticates Docker with DigitalOcean’s registry using your DigitalOcean credentials. Without this step, the build and push command fails with a 401 authentication error.
4
Build and push the Docker image to the DigitalOcean registry

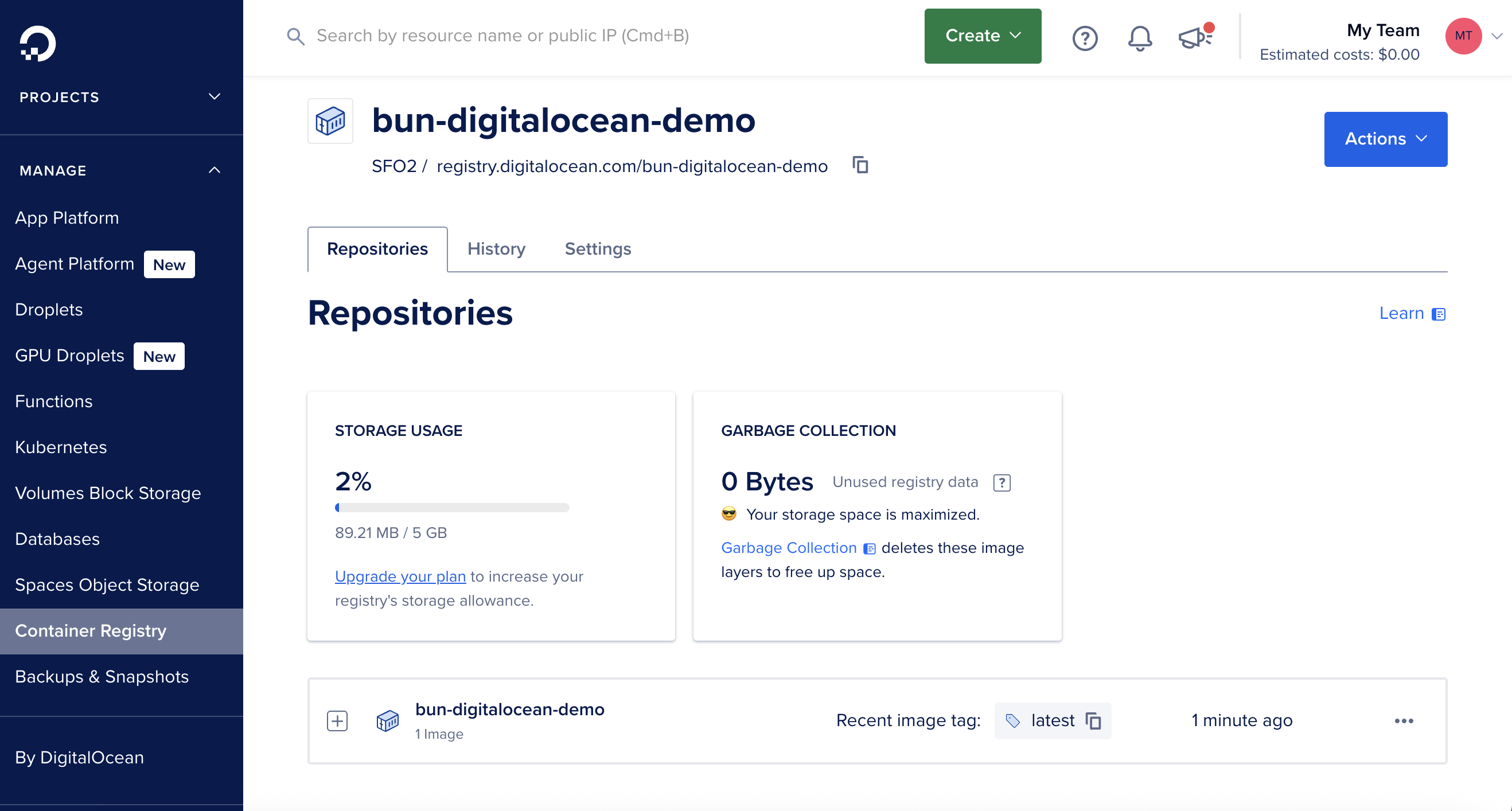

Make sure you’re in the directory containing your Once the image is pushed, you should see it in the DigitalOcean registry dashboard:
Dockerfile, then build and push the Docker image to the DigitalOcean registry in one command:terminal
If you’re building on an ARM Mac (M1/M2), you must use
docker buildx with --platform=linux/amd64 for compatibility with DigitalOcean’s infrastructure. Using docker build without the platform flag creates an ARM64 image that won’t run on DigitalOcean.
5
Create a new DigitalOcean App Platform project

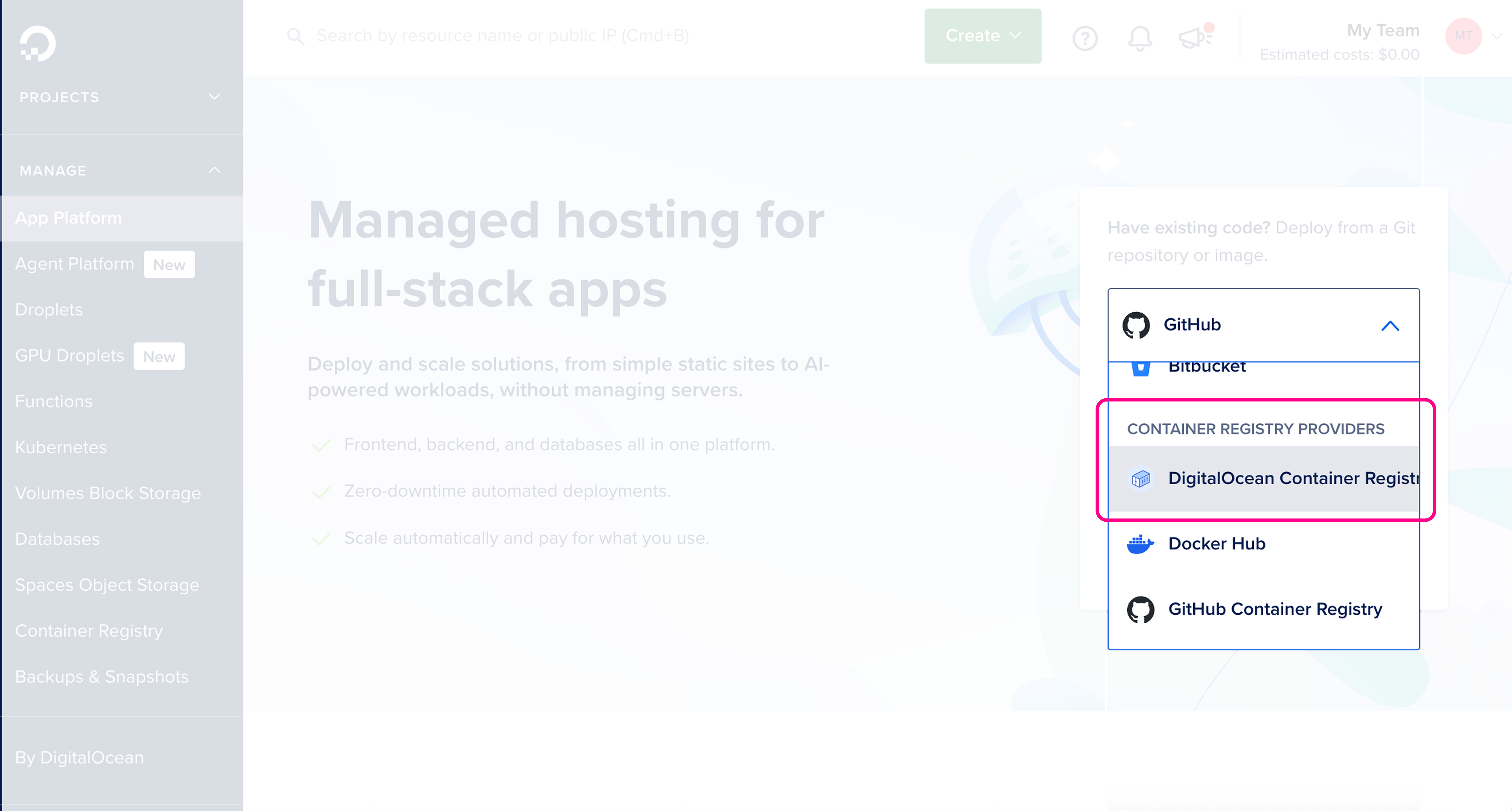

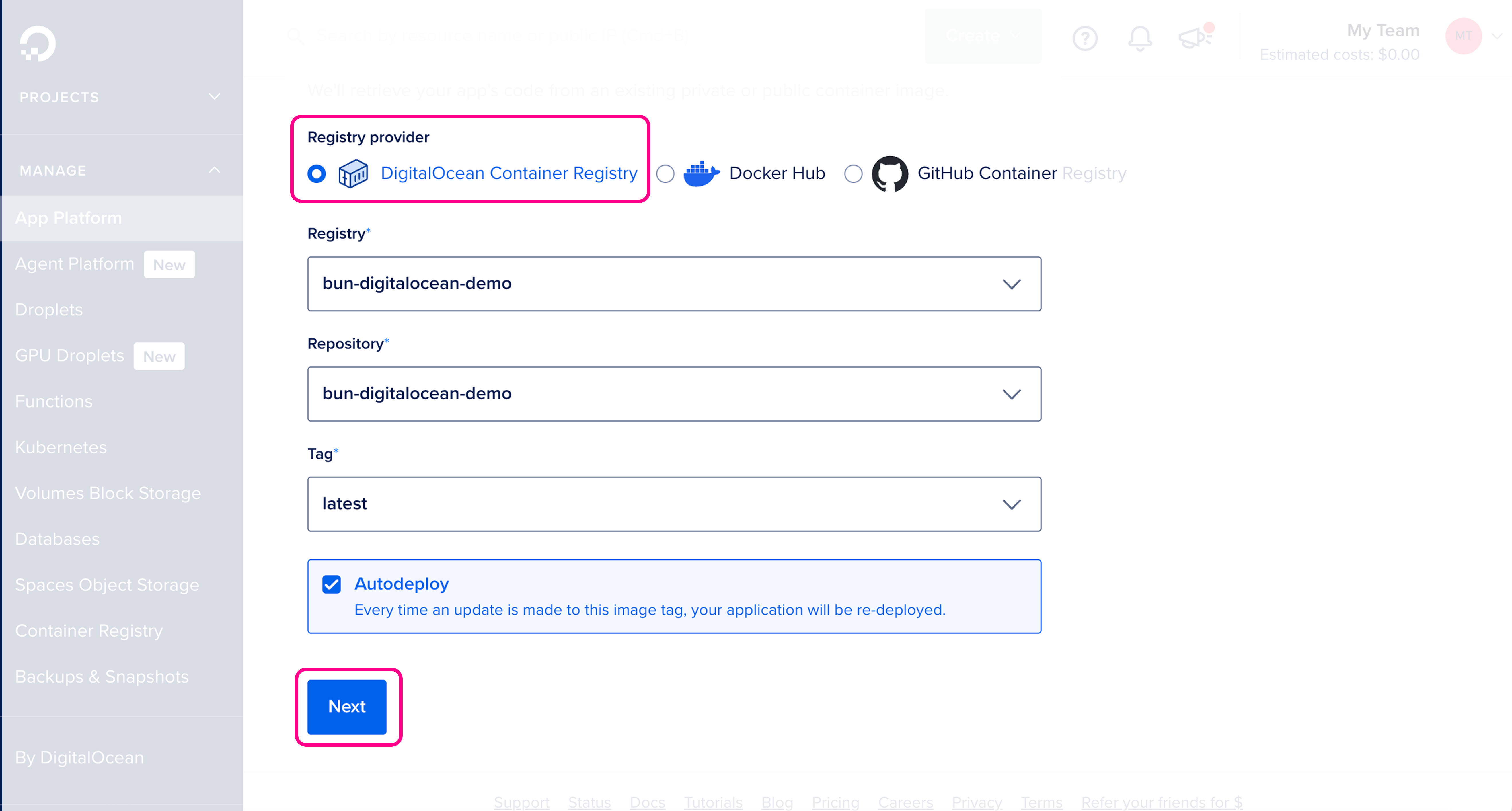

In the DigitalOcean dashboard, go to App Platform > Create App. You can create a project directly from the container image.
Make sure the details are correct, then click Next.

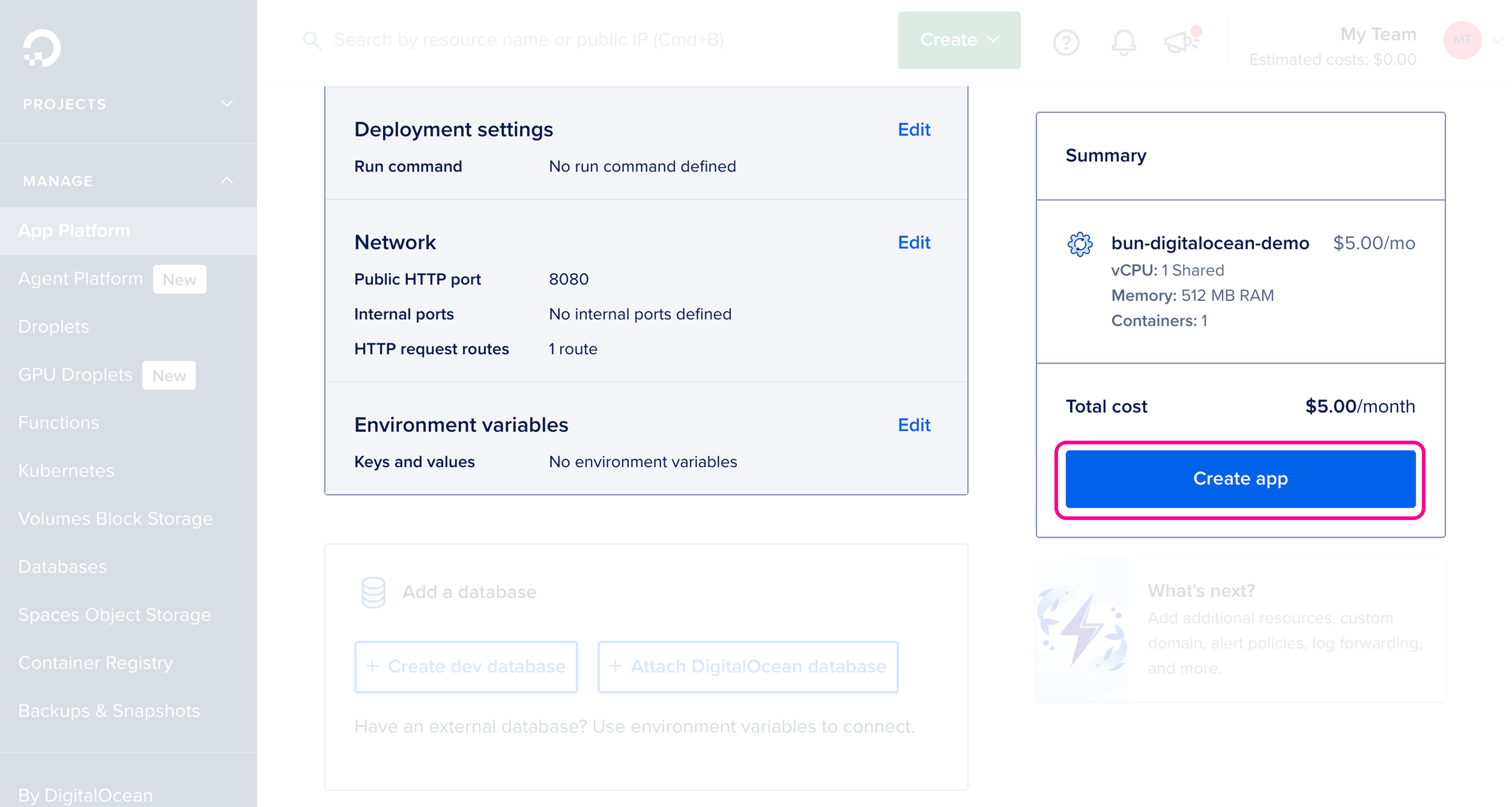

Review and configure resource settings, then click Create app.

6

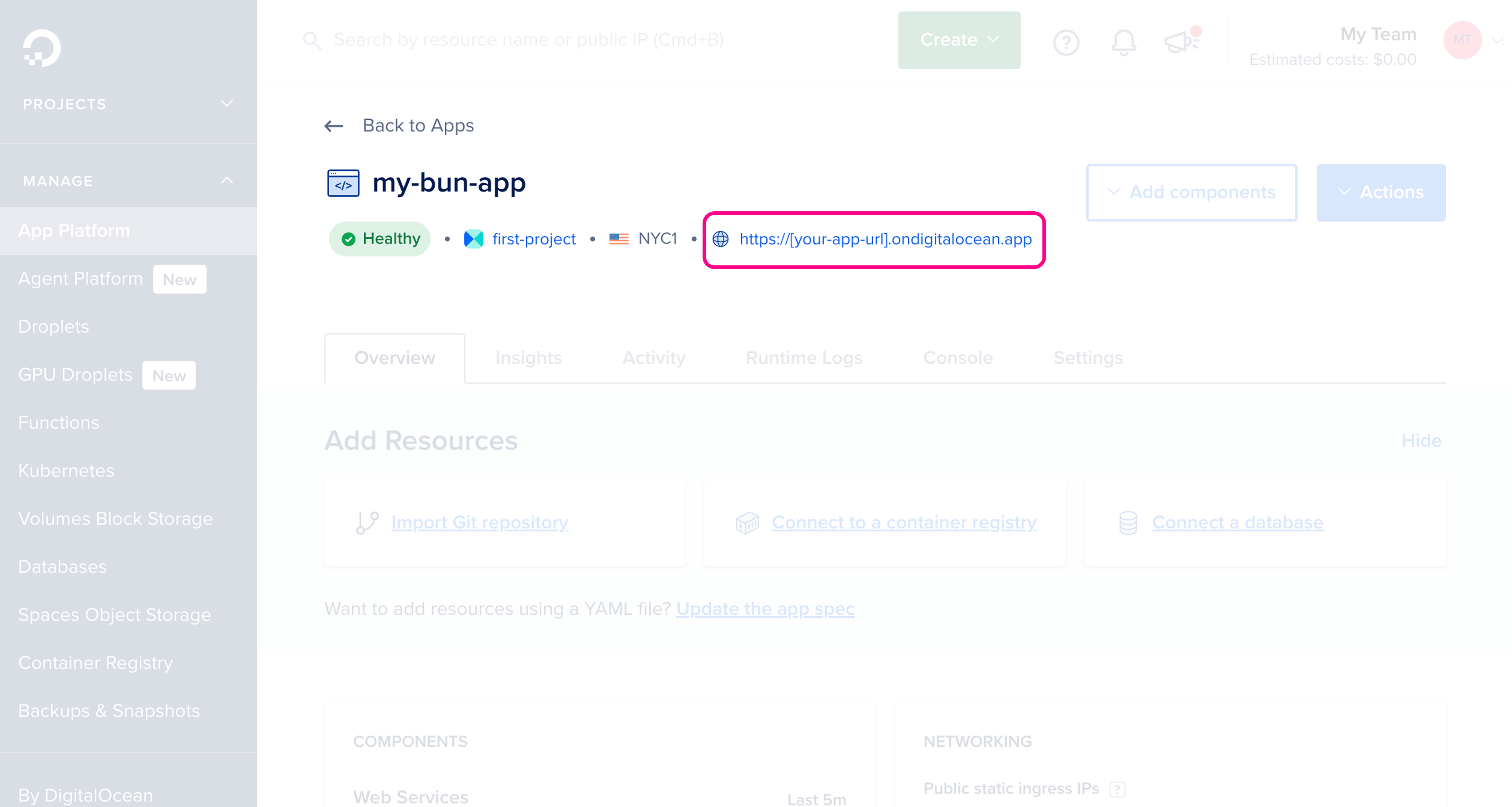

Visit your live application
Your app is now live. Once the app is created, you should see it in the App Platform dashboard with its public URL.
